Commerce Street Construction
-

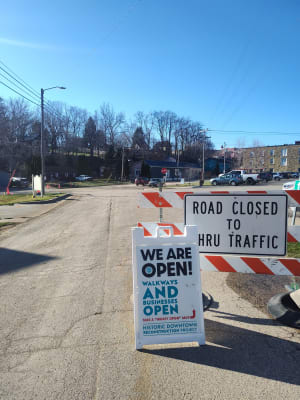

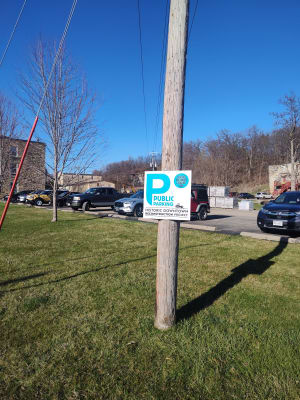

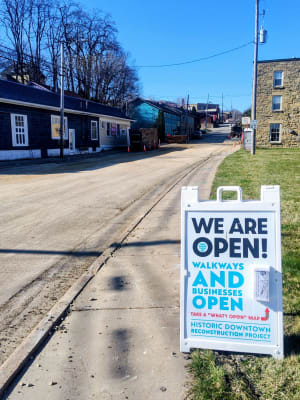

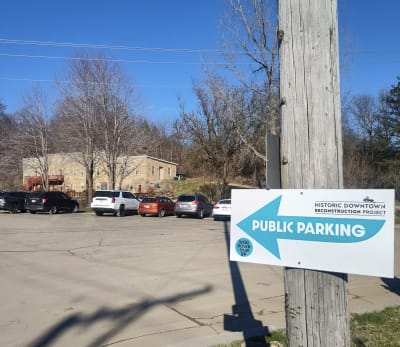

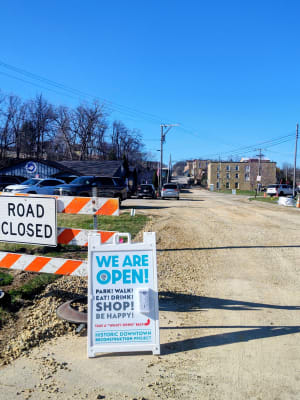

Commerce Street is under construction, but our businesses are open and ready to welcome you!
Take a look at the map, plan a stop or two, and make it a point to support the businesses along Commerce Street. Every visit makes a difference right now.
For the latest hours and updates, be sure to check each business’s Facebook page.
Participating businesses:
- Commerce Street Brewery
- Cow Tippers Pub & Eatery
- Hotel Mineral Point
- Mineral Point Railroad Museum - Opens May 1st.
- Popolo Pizzeria
- Sweet Life Ice Cream Parlor
Construction updates and map below.
-
Updates from Delta 3 - Construction Progress Update #12
Traffic Control:
- Traffic control has been installed per the project plans.
- Please continue to follow road closed/traffic control signage.
- Flagging will be provided by contractor as needed.
- Between the hours of 7:00 am and 5:30 pm the contractor has full use of areas under construction (except for emergency vehicles).
Erosion Control:
- The contractor has installed erosion control, as per the project plans.
- During periods of dry weather, the contractor must provide dust control.
- Streets will be swept throughout construction to maintain cleanliness. Dust will be common during these operations.
Contractor’s Schedule (items started/completed this week):
- The retaining wall on South Street has been installed
- Contractor has installed traffic sign bases and poles
- Contractor prepared Old Darlington Road, Front Street, and South Street for asphalt paving.
- Contractor has done some landscaping on the Project Site; there will be more landscaping in the coming weeks.
Contractor’s Schedule (two-week outlook):
- Week of June 29th:
- Contractor plans to stripe pavement on site on Tuesday, June 30th.
- Commerce and South Street will be closed for these operations
- Contractor plans to install traffic signage.
- Contractor plans to perform landscaping throughout the project site
- Contractor plans to stripe pavement on site on Tuesday, June 30th.
Utility Relocations:
- For any service interruptions for gas, electric, cable TV, telephone, and internet, you will be notified by the respective utility company prior to interruption.
- If any of these services are interrupted without notification, please contact the associated utility company in order to get service reinstalled.
Surveying:
- Delta 3 Engineering has staked for the asphalt pavement.
- Hubs are in the street, so please use caution when driving on Old Darlington Road, Front Street, and South Street so that these markers do not get disturbed.
- Also please do not disturb markers/flags for gas (yellow), electrical (red), fiber (orange), and telecommunication (orange).
Other Notes:
- If you have concerns with garbage pickup, please get in contact with the contractor so that they can properly dispose of any garbage.
Updates from Delta 3 - Construction Progress Update #11
Traffic Control:
- Traffic control has been installed per the project plans.
- Please continue to follow road closed/traffic control signage.
- Flagging will be provided by contractor as needed.
- Between the hours of 7:00 am and 5:30 pm the contractor has full use of areas under construction (except for emergency vehicles).
Erosion Control:
- The contractor has installed erosion control, as per the project plans.
- During periods of dry weather, the contractor must provide dust control.
- Streets will be swept throughout construction to maintain cleanliness. Dust will be common during these operations.
Contractor’s Schedule (items started/completed this week):
- Contractor completed concrete sidewalk on Commerce and South Street
- All sidewalk on the Project Site is accessible to pedestrian traffic
- Contractor completed concrete pavement on Commerce Street
- Please do not drive on Commerce Street until the road is open to vehicular traffic.
- An update will be sent out once the road is opened to traffic.
- Contractor has done some landscaping on the Project Site; there will be more landscaping in the coming weeks.
- Utility poles have been removed on the Project Site
- Contractor has installed light pole bases and has begun installing light poles
Contractor’s Schedule (two-week outlook):
- Week of June 22nd:
- Contractor plans to install a retaining wall on South Street
- Contractor plans to install street signage throughout the Project Site
- Contractor plans to prepare for asphalt paving.
- Asphalt paving is scheduled for Friday June 26th.
- South Street and Commerce Street will be closed for these operations.
- Week of June 29th:
- Contractor plans to stripe pavement on site
- Commerce and South Street will be closed for these operations
- Contractor plans to perform landscaping throughout the project site
- Contractor plans to stripe pavement on site
Surveying:
- Delta 3 Engineering is planning to perform staking for the asphalt pavement the week on June 22nd.
- Hubs will be in the street, so please use caution when driving on Commerce and South Street so that these markers do not get disturbed.
- Also please do not disturb markers/flags for gas (yellow), electrical (red), fiber (orange), and telecommunication (orange).
Other Notes:
- If you have concerns with garbage pickup, please get in contact with the contractor so that they can properly dispose of any garbage.
Updates from Delta 3 - Construction Progress Update #10
Traffic Control:
- Traffic control has been installed per the project plans.
- The contractor will maintain traffic control during this project.
- Flagging will be provided by contractor as needed.
- Please continue to follow road closed/traffic control signage.
- Between the hours of 7:00 am and 5:30 pm the contractor has full use of areas under construction (except for emergency vehicles).
Erosion Control:
- The contractor has installed erosion control, as per the project plans.
- During periods of dry weather, the contractor must provide dust control.
- Streets will be swept throughout construction to maintain cleanliness. Dust will be common during these operations.
Contractor’s Schedule (items started/completed this week):
- Contractor completed all concrete curb and gutter on Commerce Street
- Please, do not drive over the new curb for a minimum of 7 days
- Contractor prepping sidewalk areas on Commerce and South Street for Concrete
- Contractor set sidewalk forms today (Friday June 5th) to prepare for concrete sidewalk installation that is planned for Monday (June 8th)
- Please, do not disturb stakes and wooden forms over the weekend
Contractor’s Schedule (two-week outlook):
- Week of June 8th:
- Monday and Tuesday:
- Contractor plans to complete concrete sidewalk on Commerce and South Street.
- Any driveways that are poured will be inaccessible for a minimum of 7 days
- These areas will be marked off with caution tape
- Contractor plans to complete concrete sidewalk on Commerce and South Street.
- Monday and Tuesday:
- Wednesday – Friday:
- Contractor plans to begin concrete pavement on Wednesday and plans to have complete by Friday.
- Commerce Street will be inaccessible for a minimum of 7 days from when the concrete is poured
- Contractor plans to begin concrete pavement on Wednesday and plans to have complete by Friday.
- Week of June 15th:
- Contractor plans to begin preparing Vine Street for concrete sidewalk replacement
- Contractor plans to prepare South Street and Old Darlington Road for asphalt pavement
Utility Relocations:
- Frontier plans on completing a cutover on Tuesday night to transition utilities from aerial cables to underground by Wednesday morning.
- Frontier plans to have utility poles on the Project Site removed on Wednesday June 10th.
- There will be more utility relocations associated with this project.
- For any service interruptions for gas, electric, cable TV, telephone, and internet, you will be notified by the respective utility company prior to interruption.
- If any of these services are interrupted without notification, please contact the associated utility company in order to get service reinstalled.
Surveying:
- Delta 3 Engineering is planning to perform staking for the concrete pavement the week on June 8th.
- Hubs will be in the street, so please use caution when driving on Commerce Street so that these markers do not get disturbed.
- Please do not disturb these markers.
- Hubs will be in the street, so please use caution when driving on Commerce Street so that these markers do not get disturbed.
- Also please do not disturb markers/flags for gas (yellow), electrical (red), fiber (orange), and telecommunication (orange).
Other Notes:
- If you have concerns with garbage pickup, please get in contact with the contractor so that they can properly dispose of any garbage that has not been picked up in the last three weeks
- Please put the building number on trash bins in order for the contractor to return them to the correct location.
Updates from Delta 3 - Construction Progress Update #9
Contractor’s Schedule (items started/completed this week):
- Contractor Excavating to subgrade on Commerce Street
- Contractor completed water main tie-ins at the following locations:
- South of the intersection of Old Darlington Road and Commerce Street
- Intersection of Fountain Street and Commerce Street.
- Contractor poured concrete curb and gutter on South Street.
- Please, do not drive over the new curb for a minimum of 7 days.
Contractor’s Schedule (two-week outlook):
- Week of May 25th
- Monday June 1st:
- Contractor plans to pour curb and gutter on Commerce Street and concrete sidewalk on South Street.
- Any driveways that are poured will be inaccessible for a minimum of 7 days.
- These areas will be marked off with caution tape.
- Contractor plans to pour curb and gutter on Commerce Street and concrete sidewalk on South Street.
- Tuesday June 2nd – Friday June 5th:
- Contractor completing excavation to subgrade on Commerce Street
- Contractor prepping Commerce Street for concrete curb and gutter and sidewalk on Commerce Street.
- Monday June 1st:
- Week of June 8th:
- Contractor plans to pour the remaining curb and gutter on Commerce Street on Monday
- Contractor plans to pour all of the concrete sidewalk on Commerce Street
- Contractor plans to begin concrete pavement on Commerce Street
- Again, once poured, these areas will be inaccessible for a minimum of 7 days and will be marked off with caution tape.
Utility Relocations:
- There will be more utility relocations associated with this project.
- For any service interruptions for gas, electric, cable TV, telephone, and internet, you will be notified by the respective utility company prior to interruption.
- If any of these services are interrupted without notification, please contact the associated utility company in order to get service reinstalled.
Surveying:
- Delta 3 Engineering has performed project staking.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- The curb and gutter has been marked with pink flag, hubs, and colored paint on South and Commerce Streets.
- Please do not disturb these markers.
- Also please do not disturb markers/flags for gas (yellow), electrical (red), fiber (orange), and telecommunication (orange).
Other Notes:
- If you have concerns with garbage pickup, please get in contact with the contractor so that they can properly dispose of any garbage that has not been picked up in the last three weeks
- Please put the building number on trash bins in order for the contractor to return them to the correct location.
Updates from Delta 3 - Construction Progress Update #8
Traffic Control:
- Traffic control has been installed per the project plans.
- The contractor will maintain traffic control during this project.
- Flagging will be provided by contractor as needed.
- Please continue to follow road closed/traffic control signage.
- Between the hours of 7:00 am and 5:30 pm the contractor has full use of areas under construction (except for emergency vehicles).
Erosion Control:
- The contractor has installed erosion control, as per the project plans.
- During periods of dry weather, the contractor must provide dust control.
- Streets will be swept throughout construction to maintain cleanliness. Dust will be common during these operations.
Contractor’s Schedule (items started/completed):
- Began replacing/reconnecting water services on Commerce Street from Cowtippers to Wisconsin Electrical Service
- Installed all sanitary sewer laterals on Commerce Street
- Installed storm sewer catch basins from 105 to 103 Commerce Street
- Completed subgrade excavation on South Street and placed road base.
Contractor’s Schedule (two-week outlook):
- Week of May 25th
- Contractor plans to complete water main tie-ins on Tuesday May 26th at the following locations:
- South of the intersection of Old Darlington Road and Commerce Street
- Intersection of Fountain Street and Commerce Street
- Contractor plans to complete all remaining water services on Commerce Street
- Contractor plans to complete all remaining storm sewer installations on Commerce Street
- Contractor plans to begin subgrade excavation on Commerce Street from the intersection of Old Darlington Road and Commerce St. and will move north
- Contractor plans to complete water main tie-ins on Tuesday May 26th at the following locations:
- Week of June 1st
- Contractor plans to pour concrete curb and gutter on Commerce and South Street
- An email update will be provided when the specific date is known.
- Contractor plans to begin preparing for concrete sidewalk installation on South and Commerce Street.
- Contractor plans to pour concrete curb and gutter on Commerce and South Street
Utility Relocations:
- There will be more utility relocations associated with this project.
- For any service interruptions for gas, electric, cable TV, telephone, and internet, you will be notified by the respective utility company prior to interruption.
- If any of these services are interrupted without notification, please contact the associated utility company in order to get service reinstalled.
Surveying:
- Delta 3 Engineering has performed project staking.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- The curb and gutter has been marked with pink flags, hubs, and colored paint on South and Commerce Streets.
- Please do not disturb these markers.
- Also please do not disturb markers/flags for gas (yellow), electrical (red), fiber (orange), and telecommunication (orange).
Other Notes:
- If you have concerns with garbage pickup, please get in contact with the contractor so that they can properly dispose of any garbage that has not been picked up in the last three weeks
- Please put the building number on trash bins in order for the contractor to return them to the correct location.
Updates from Delta 3 - Construction Progress Update #7
Traffic Control:
- Traffic control has been installed per the project plans.
- The contractor will maintain traffic control during this project.
- Flagging will be provided by contractor as needed.
- Please continue to follow road closed/traffic control signage.
- Between the hours of 7:00 am and 5:30 pm the contractor has full use of areas under construction (except for emergency vehicles).
Erosion Control:
- The contractor has installed erosion control, as per the project plans.
- During periods of dry weather, the contractor must provide dust control.
- Streets will be swept throughout construction to maintain cleanliness. Dust will be common during these operations.
Contractor’s Schedule (items started/completed):
- Completed sanitary sewer main on South Street
- Completed all sanitary sewer laterals on South Street
- Completed storm sewer at the intersection of Front Street and Commerce Street
- Completed a water main tie-in on Front Street and completed associated water main pressure and safe sample tests
- Completed all water services on South Street
- Started removing sidewalk and curb on Commerce Street from the intersection of Old Darlington Road to 23 Commerce Street
Contractor’s Schedule (two-week outlook):
- Week of May 18th
- Contractor plans to complete all sanitary sewer laterals on Commerce Street
- Contractor plans to complete all water services on Commerce Street
- Contractor plans to complete water main tie-ins:
- South of the intersection of Old Darlington Road and Commerce Street
- Intersection of Fountain Street and Commerce Street.
- Contractor plans to complete storm sewer catch basin installation on Commerce and South Street
- Contractor plans to begin undercutting South Street
- Week of May 25th
- Contractor plans to finish undercutting South Street
- Contractor plans to begin undercutting Commerce Street at the intersection of Old Darlington Road and Commerce Street.
Utility Relocations:
- There will be more utility relocations associated with this project.
- For any service interruptions for gas, electric, cable TV, telephone, and internet, you will be notified by the respective utility company prior to interruption.
- If any of these services are interrupted without notification, please contact the associated utility company in order to get service reinstalled.
Surveying:
- Delta 3 Engineering has performed project staking.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- Please do not disturb these markers.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- Also please do not disturb markers/flags for gas (yellow), electrical (red), fiber (orange), and telecommunication (orange).
Other Notes:
- If you have concerns with garbage pickup, please get in contact with the contractor so that they can properly dispose of any garbage that has not been picked up in the last three weeks
- Please put the building number on trash bins in order for the contractor to return them to the correct location.
Updates from Delta 3 - Construction Progress Update #6
Traffic Control:
- Traffic control has been installed per the project plans.
- The contractor will maintain traffic control during this project.
- Flagging will be provided by contractor as needed.
- Please continue to follow road closed/traffic control signage.
- Between the hours of 7:00 am and 5:30 pm the contractor has full use of areas under construction (except for emergency vehicles).
Erosion Control:
- The contractor has installed erosion control, as per the project plans.
- During periods of dry weather, the contractor must provide dust control.
- Streets will be swept throughout construction to maintain cleanliness. Dust will be common during these operations.
Contractor’s Schedule (items started/completed):
- Contractor completed water main from South Street to the intersection of Fountain and Commerce Street.
- Contractor has installed sanitary sewer main on South Street from the intersection of South and Commerce Street to The Board Shoppe.
- Contractor completed sanitary spot repairs at the intersection of Old Darlington Road and Commerce Street.
- Contractor has completed storm sewer at the intersection of Old Darlington Road and Commerce Street.
Contractor’s Schedule (two-week outlook):
- Week of May 11th
- Contractor plans to perform a water main tie-in on Front Street on Monday May 11th.
- Contractor plans to complete sanitary sewer main on South Street from The Board Shoppe to Vine Street.
- Contractor plans to install all sanitary sewer laterals on South and Commerce Street.
- Contractor plans to install Storm Sewer at the intersection of Front Street and Commerce Street.
- Contractor plans to install water services throughout Commerce Street.
- Week of May 18th
- Contractor plans to finish installing water services throughout Commerce Street.
- Contractor plans to finish all remaining storm sewer on the Project site.
- Contractor plans to begin undercutting Commerce Street at the intersection of Old Darlington Road and Commerce Street.
Utility Relocations:
- There will be more utility relocations associated with this project.
- For any service interruptions for gas, electric, cable TV, telephone, and internet, you will be notified by the respective utility company prior to interruption.
- If any of these services are interrupted without notification, please contact the associated utility company in order to get service reinstalled.
Surveying:
- Delta 3 Engineering has performed project staking.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- Please do not disturb these markers.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- Also please do not disturb markers/flags for gas (yellow), electrical (red), fiber (orange), and telecommunication (orange).
Other Notes:
- If you have concerns with garbage pickup, please get in contact with the contractor so that they can properly dispose of any garbage that has not been picked up.
- Please put the building number on trash bins in order for the contractor to return them to the correct location.
Updates from Delta 3 - Construction Progress Update #5
Traffic Control:
- Traffic control has been installed per the project plans.
- The contractor will maintain traffic control during this project.
- Flagging will be provided by contractor as needed.
- Please continue to follow road closed/traffic control signage.
- Between the hours of 7:00 am and 5:30 pm the contractor has full use of areas under construction (except for emergency vehicles).
Erosion Control:
- The contractor has installed erosion control, as per the project plans.
- During periods of dry weather, the contractor must provide dust control.
- Streets will be swept throughout construction to maintain cleanliness. Dust will be common during these operations.
Contractor’s Schedule (items started/completed):
- Contractor completed water main from 23 Commerce Street to South Street
- Contractor has completed all remaining sanitary sewer main on Commerce Street
- Contractor began installing storm sewer from Brewery Creek to the intersection of Old Darlington Road and Commerce Street
Contractor’s Schedule (two-week outlook):
- Week of May 4th
- Contractor plans to complete spot repairs on the sanitary sewer at the intersection of Old Darlington Road and Commerce Street
- Contractor plans to complete sanitary sewer main installation on South Street
- Contractor Plans to install storm sewer at the intersection of Front Street and Commerce Street
- Contractor plans to perform a water main tie in on Front Street
- Potential water shutoff/tie-in this week
- Contractor Plans to Complete water main from South Street to the intersection of Fountain Street and Commerce Street
- Week of May 11th
- Contractor plans to begin installing water services throughout Commerce Street
- Contractor plans to begin installing sanitary sewer laterals throughout South Street and Commerce Street
- Contractor plans to install storm sewer at the intersection of Old Darlington Road and Commerce Street
Utility Relocations:
- There will be more utility relocations associated with this project.
- For any service interruptions for gas, electric, cable TV, telephone, and internet, you will be notified by the respective utility company prior to interruption.
- If any of these services are interrupted without notification, please contact the associated utility company in order to get service reinstalled.
Surveying:
- Delta 3 Engineering has performed project staking.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- Please do not disturb these markers.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- Also please do not disturb markers/flags for gas (yellow), electrical (red), fiber (orange), and telecommunication (orange).
Other Notes:
- If you have concerns with garbage pickup, please get in contact with the contractor so that they can properly dispose of any garbage that has not been picked up in the last three weeks
- Please put the building number on trash bins in order for the contractor to return them to the correct location.
Updates from Delta 3 - Construction Progress Update #4
Traffic Control:
- Traffic control has been installed per the project plans.
- The contractor will maintain traffic control during this project.
- Flagging will be provided by contractor as needed.
- Please follow road closed/traffic control signage.
- Between the hours of 7:00 am and 5:30 pm the contractor has full use of areas under construction (except for emergency vehicles).
Erosion Control:
- The contractor has installed erosion control, as per the project plans.
- During periods of dry weather, the contractor must provide dust control.
- Streets will be swept throughout construction to maintain cleanliness. Dust will be common during these operations.
Contractor’s Schedule (items started/completed):
- Contractor has begun installing storm sewer on Commerce Street
- Contractor has begun installing storm sewer on South Street
- Contractor has begun installing sanitary sewer main at the intersection of Commerce Street and Old Darlington Road and are moving north.
- Contractor has begun installing water main south of the intersection of Commerce Street and Old Darlington Road and are moving north.
Contractor’s Schedule (two-week outlook):
- Week of April 27th
- Contractor plans to finish installing sanitary sewer main on Commerce Street
- Contractor plans to finish installing sanitary sewer main on South Street
- Contractor plans to continue installing water main on Commerce Street
- Contractor plans to continue installing storm sewer on Commerce Street and South Street.
- Week of May 4th
- Contractor plans to continue installing water main on Commerce Street
- Contractor plans to begin installing water services
- Contractor plans to begin installing sanitary sewer laterals
- Contractor plans to continue installing storm sewer on Commerce Street and South Street.
Utility Relocations:
- There will be more utility relocations associated with this project.
- For any service interruptions for gas, electric, cable TV, telephone, and internet, you will be notified by the respective utility company prior to interruption.
- If any of these services are interrupted without notification, please contact the associated utility company in order to get service reinstalled.
Surveying:
- Delta 3 Engineering has performed project staking.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- Please do not disturb these markers.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- Also please do not disturb markers/flags for gas (yellow), electrical (red), fiber (orange), and telecommunication (orange).
Other Notes:
- If you have concerns with garbage pickup, please get in contact with the contractor so that they can properly dispose of any garbage that has not been picked up in the last three weeks.
- Please put your building number on trash bins so that the contractor can return them to the correct location.
Updates from Delta 3 - Construction Progress Update #3
Traffic Control:
- Traffic control has been installed per the project plans.
- The contractor will maintain traffic control during this project.
- Flagging will be provided by contractor as needed.
- Please follow road closed/traffic control signage.
- Between the hours of 7:00 am and 5:30 pm the contractor has full use of areas under construction (except for emergency vehicles).
Erosion Control:
- The contractor has installed erosion control, as per the project plans.
- During periods of dry weather, the contractor must provide dust control.
- Streets will be swept throughout construction to maintain cleanliness. Dust will be common during these operations.
Contractor’s Schedule (items started/completed):
- Contractor has completed installation of storm sewer between 105 and 23 Commerce Street
- Contractor has begun installing storm sewer on Commerce Street
- Contractor has begun installing sanitary sewer main at the intersection of Commerce Street and Old Darlington Road and are moving north.
- Contractor has begun installing water main south of the intersection of Commerce Street and Old Darlington Road and are moving north.
Contractor’s Schedule (two-week outlook):
- Week of April 20th
- Contractor plans to continue installing water main on Commerce Street
- Contractor plans to continue installing storm sewer on Commerce Street.
- Contractor plans to begin installing storm sewer on South Street.
- Residents will be unable to access South Street with vehicles between 7:00 am and 5:30 pm
- Contractor plans to continue installing sanitary sewer main on Commerce Street
- Week of April 27th
- Contractor plans to continue installing water main on Commerce Street
- Contractor plans to continue installing storm sewer on Commerce Street and South Street.
- Contractor plans to continue installing sanitary sewer on Commerce Street.
- Contractor may begin installing sanitary sewer on South Street
Utility Relocations:
- There will be more utility relocations associated with this project.
- For any service interruptions for gas, electric, cable TV, telephone, and internet, you will be notified by the respective utility company prior to interruption.
- If any of these services are interrupted without notification, please contact the associated utility company in order to get service reinstalled.
Surveying:
- Delta 3 Engineering has performed project staking.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- Please do not disturb these markers.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- Also please do not disturb markers/flags for gas (yellow), electrical (red), fiber (orange), and telecommunication (orange).
Updates from Delta 3 - Construction Progress Update #2
The following is an update as to what has happened recently on-site and what is planned to happen over the next two weeks:
Traffic Control:
- Traffic control has been installed per the project plans.
- The contractor will maintain traffic control during this project.
- Flagging will be provided by contractor as needed.
- Please follow road closed/traffic control signage.
- Between the hours of 7 am and 5:30 pm the contractor has full use of areas under construction (except for emergency vehicles).
Erosion Control:
- The contractor has installed erosion control, as per the project plans.
- During periods of dry weather, the contractor must provide dust control.
- Streets will be swept throughout construction to maintain cleanliness. Dust will be common during these operations.
Contractor’s Schedule (items started/completed):
- Contractor has completed Crack and Damage surveys for the Project.
- Contractor has begun installing water main south of the intersection of Commerce Street and Old Darlington Road and are moving north.
- Contractor has begun installing storm sewer between 105 and 23 Commerce Street.
Contractor’s Schedule (two-week outlook):
- Week of April 13th
- Contractor will continue installing water main on Commerce Street
- Contractor will continue installing storm sewer between 105 and 23 Commerce Street
- Contractor will begin installing storm sewer on Commerce Street and South Street (weather dependent).
- Contractor may begin installing sanitary sewer at the intersection of Commerce Street and Old Darlington Road and will move north.
- Possible scheduled water shutoff on Wednesday or Thursday. Once the exact date is known, residents/businesses/etc. will be notified.
- Week of April 20th
- Contractor plans to continue installing water main on Commerce Street
- Contractor plans to continue installing storm sewer on Commerce Street and South Street
- Contractor plans to continue or start installing sanitary sewer main on Commerce Street
Utility Relocations:
- There will be more utility relocations associated with this project.
- For any service interruptions for gas, electric, cable TV, telephone, and internet, you will be notified by the respective utility company prior to interruption.
- If any of these services are interrupted without notification, please contact the associated utility company in order to get service reinstalled.
Surveying:
- Delta 3 Engineering has performed project staking.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- Please do not disturb these markers.
- The sanitary sewer, water main, and storm sewer on Commerce Street has been marked with pink flags, wooden hubs and colored paint.
- Also please do not disturb markers/flags for gas (yellow), electrical (red), fiber (orange), and telecommunication (orange).
-
